TWO-SIDED ASSEMBLY LINE
Estimation of Final Results
Waldemar Grzechca
Institute of Automatic Control, The Silesian University of Technology, ul.Akademicka 16, 44-100 Gliwice, Poland
Keywords: Assembly line balancing, Two-sided structure, Line time, Line efficiency, Smoothness index.
Abstract: The paper considers simple assembly line balancing problem and two-sided assembly line structure. In the
last four decades a large variety of heuristic and exact solutions procedures have been proposed to balance
one-sided assembly line in the literature. Some heuristic were given to balance two-sided lines, too. Some
measures of solution quality have appeared in line balancing literature: balance delay (BD), line efficiency
(LE), line time (LT) and smoothness index (SI). These measures are very important for estimation the
balance solution quality. Author of this paper modified and discussed the line time and smoothness for two-
sided assembly line. Some problems, which appeared during evaluations, are mentioned.
1 INTRODUCTION
The manufacturing assembly line was first
introduced by Henry Ford in the early 1900’s. It was
designed to be an efficient, highly productive way of
manufacturing a particular product. The basic
assembly line consists of a set of workstations
arranged in a linear fashion, with each station
connected by a material handling device. The basic
movement of material through an assembly line
begins with a part being fed into the first station at a
predetermined feed rate. A station is considered any
point on the assembly line in which a task is
performed on the part. These tasks can be performed
by machinery, robots, and/or human operators. Once
the part enters a station, a task is then performed on
the part, and the part is fed to the next operation. The
time it takes to complete a task at each operation is
known as the process time (Sury, 1971). The cycle
time of an assembly line is predetermined by a
desired production rate. This production rate is set so
that the desired amount of end product is produced
within a certain time period (Baybars, 1986). For
instance, the production rate might be set at 480
parts per day. Assuming an eight-hour shift, this
translates into a requirement of 60 parts per hour (1
part per minute) being produced by the assembly
line. In order for the assembly line to maintain a
certain production rate, the sum of the processing
times at each station must not exceed the stations’
cycle time (Fonseca et. al, 2005). If the sum of the
processing times within a station is less than the
cycle time, idle time is said to be present at that
station (Erel, Erdal and Sarin, 1998). One of the
main issues concerning the development of an
assembly line is how to arrange the tasks to be
performed. This arrangement may be somewhat
subjective, but has to be dictated by implied rules set
forth by the production sequence (Kao, 1976). For
the manufacturing of any item, there are some
sequences of tasks that must be followed. The
assembly line balancing problem (ALBP) originated
with the invention of the assembly line. Helgeson et.
al (Helgeson and Birnie, 1961) were the first to
propose the ALBP, and Salveson (Salveson, 1955)
was the first to publish the problem in its
mathematical form. However, during the first forty
years of the assembly line’s existence, only trial-
and-error methods were used to balance the lines
(Erel, Erdal and Sarin, 1998). Since then, there have
been numerous methods developed to solve the
different forms of the ALBP. Salveson (Salveson,
1955) provided the first mathematical attempt by
solving the problem as a linear program. Gutjahr and
Nemhauser (Gutjahr and Nemhauser, 1964) showed
that the ALBP problem falls into the class of NP-
hard combinatorial optimization problems. This
means that an optimal solution is not guaranteed for
problems of significant size. Therefore, heuristic
methods have become the most popular techniques
for solving the problem.
231
Grzechca W. (2008).
TWO-SIDED ASSEMBLY LINE - Estimation of Final Results.
In Proceedings of the Fifth International Conference on Informatics in Control, Automation and Robotics - ICSO, pages 231-237
DOI: 10.5220/0001500102310237
Copyright
c
SciTePress
2 TWO-SIDED ASSEMBLY LINE
Two-sided assembly lines are typically found in
producing large-sized products, such as trucks and
buses. Assembling these products is in some
respects different from assembling small products.
Some assembly operations prefer to be performed at
one of the two sides (Bartholdi, 1993).
Station n
Conveyor
Station 1 Station 3
Station (n-2) Station 4 Station 2
Station (n-3) Station (n-1)

Figure 1: Two-sided assembly line.
Let us consider, for example, a truck assembly
line. Installing a gas tank, air filter, and toolbox can
be more easily achieved at the left-hand side of the
line, whereas mounting a battery, air tank, and
muffler prefers the right-hand side. Assembling an
axle, propeller shaft, and radiator does not have any
preference in their operation directions so that they
can be done at any side of the line. The
consideration of the preferred operation directions is
important since it can greatly influence the
productivity of the line, in particular when assigning
tasks, laying out facilities, and placing tools and
fixtures in a two-sided assembly line (Kim et. al,
2001). A two-sided assembly line in practice can
provide several substantial advantages over a one-
sided assembly line (Bartholdi, 1993). These include
the following: (1) it can shorten the line length,
which means that fewer workers are required, (2) it
thus can reduce the amount of throughput time, (3) it
can also benefit from lowered cost of tools and
fixtures since they can be shared by both sides of a
mated-station, and (4) it can reduce material
handling, workers movement and set-up time, which
otherwise may not be easily eliminated. These
advantages give a good reason for utilizing two-
sided lines for assembling large-sized products.
A line balancing problem is usually represented
by a precedence diagram as illustrated in Figure 2. A
circle indicates a task, and an arc linking two tasks
represents the precedence relation between the tasks.
Each task is associated with a label of (t
i
, d), where t
i
is the task processing time and d (=L, R or E) is the
preferred operation direction. L and R, respectively,
indicate that the task should be assigned to a left-
and a right-side station. A task associated with E can
be performed at either side of the line.
While balancing assembly lines, it is generally
needed to take account of the features specific to the
lines. In a one-sided assembly line, if precedence
relations are considered appropriately, all the tasks
assigned to a station can be carried out continuously
without any interruption. However, in a two-sided
assembly line, some tasks assigned to a station can
be delayed by the tasks assigned to its companion
(Bartholdi, 1993). In other words, idle time is
sometimes unavoidable even between tasks assigned
to the same station. Consider, for example, task j and
its immediate predecessor i. Suppose that j is
assigned to a station and i to its companion station.
Task j cannot be started until task i is completed.
Therefore, balancing such a two-sided assembly
line, unlike a one-sided assembly line, needs to
consider the sequence-dependent finish time of
tasks.

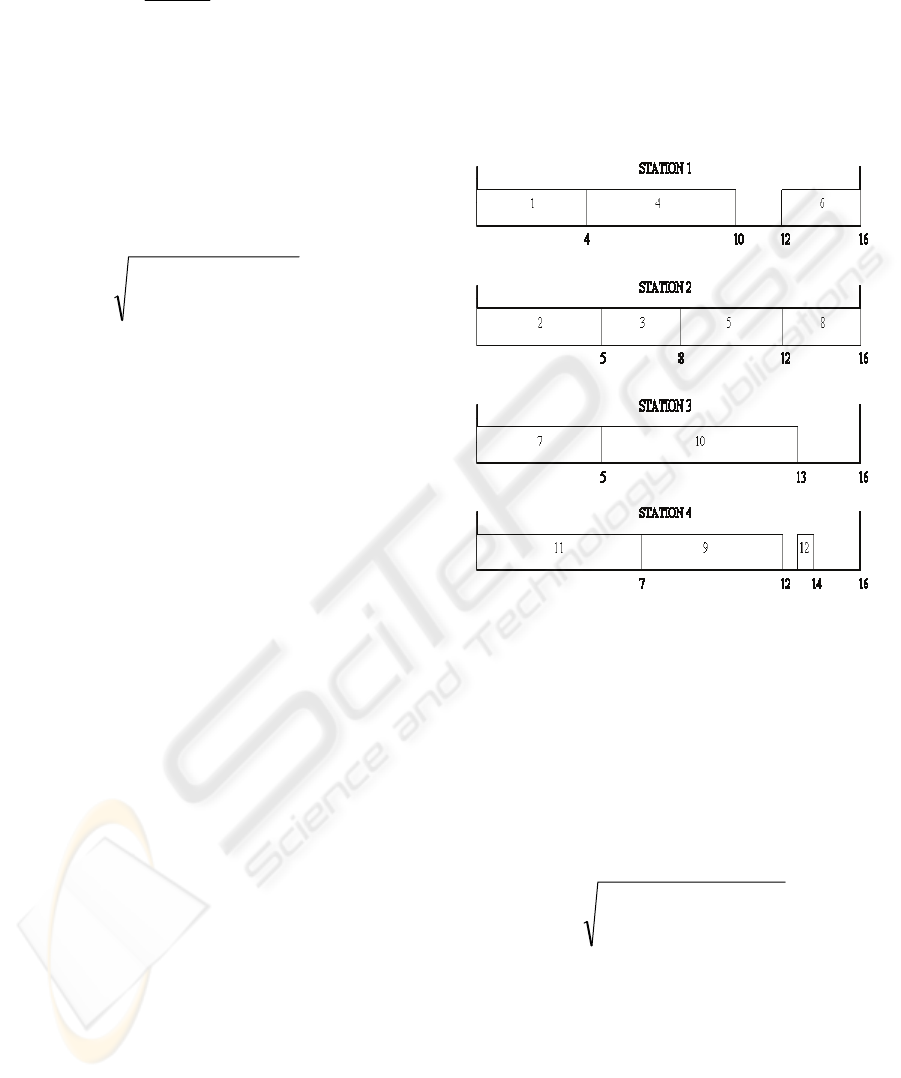

Figure 2: Precedence graph (cycle time =16).
This notion of sequence dependency further
influences the treatment of cycle time constraint.
Every task assigned to a station must be able to be
completed within a predetermined cycle time. In a
one-sided assembly line, this can readily be achieved
by checking the total operation time of tasks
assigned to a station. Therefore, a task not violating
any precedence constraints can be simply added to
the station if the resulting total amount of operation
time does not exceed the cycle time. However, in a
two-sided assembly line, due to the above sequence-
dependent delay of tasks, the cycle time constraint
should be more carefully examined. The amount of
time required to perform tasks allocated to a station
is determined by the task sequences in both sides of
the mated-station as well as their operation time. It
should be mentioned that two-sided assembly line is
a special case of single assembly line. Therefore it is
possible to use some procedures and measurements,
which were for simple assembly line developed.
1
4
5
2
3
6
7
8
9
10
11
12
(4, L)
(5, E)
(3, R)
(
6
, L)
(4, E)
(4, R)
(5, L)
(4, E) (5, E)
(8, E)
(
7
, E)
(1, R)
ICINCO 2008 - International Conference on Informatics in Control, Automation and Robotics
232
3 HEURISTIC APPROACH
3.1 Grouping Tasks
A task group consists of a considered task i and all
of its predecessors. Such groups are generated for
every un–assigned task. As mentioned earlier,
balancing a two–sided assembly line needs to
additionally consider operation directions and
sequence dependency of tasks, while creating new
groups (Kim et. al, 2005).
While forming initial groups IG(i), the operation
direction is being checked all the time. It’s
disallowed for a group to contain tasks with
preferred operation direction from opposite sides.
But, if each task in initial group is E – task, the
group can be allocated to any side. In order to
determine the operation directions for such groups,
the rules (direction rules DR) are applied:
DR 1. Set the operation direction to the side where
tasks can be started earlier.
DR 2. The start time at both sides is the same, set the
operation direction to the side where it’s expected to
carry out a less amount of tasks (total operation time
of unassigned L or R tasks).
Generally, tasks resulting from “repeatability test”
are treated as starting ones. But there is exception in
form of first iteration, where procedure starts from
searching tasks (initial tasks IT), which are the first
ones in precedence relation. After the first step in the
first iteration we get:
IG (1) = {1}, Time{IG (1)} = 2, Side{IG (1)} = ‘L’
IG (2) = {2}, Time{IG (2)} = 5, Side{IG (2)} = ‘E’
IG (3) = {3}, Time{IG (3)} = 3, Side{IG (3)} = ‘R
where:
Time{IG(i)} – total processing time of i
th
initial
group,
Side{IG(i)} – preference side of i
th
initial group.
To those who are considered to be the first, the next
tasks will be added, (these ones which fulfil
precedence constraints).
Whenever new tasks are inserted to the group i, the
direction, cycle time and number of immediate
predecessors are checked. If there are more
predecessors than one, the creation of initial group j
comes to the end.
First iteration – second step
IG (1) = {1, 4, 6}, Time{IG (1)} = 8, Side{IG (1)}
= ‘L’
IG (2) = {2, 5}, Time{IG (2)} = 9 , Side{IG (2)} =
‘E’
IG (3) = {3, 5} , Time{IG (3)} = 7 , Side{IG (3)} =
‘R’
When set of initial groups is created, the last
elements from those groups are tested for
repeatability. If last element in set of initial groups
IG will occur more than once (groups pointed by
arrows), the groups are intended to be joined – if
total processing time (summary time of considered
groups) is less or equal to cycle time. Otherwise,
these elements are deleted.
In case of occurring only once, the last member
is being checked if its predecessors are not contained
in Final set FS. If not, it’s removed as well. So far,
FS is empty.
First iteration – third step
IG (1) = {1, 4}, Time{IG (1)} = 4, Side{IG (1)} =
‘L’
IG (2) = {2, 3, 5}, Time{IG (2)} = 12, Side{IG (2)}
= ‘R’
Whenever two or more initial groups are joined
together, or when initial group is connected with
those one coming from Final set – the “double task”
is added to initial tasks needed for the next iteration.
In the end of each iteration, created initial groups are
copied to FS.
First iteration – fourth step
FS = { (1, 4); (2, 3, 5) },
Side{FS (1)} = ‘L’, Side{FS (2)} = ‘R
Time {FS(2)} = 12, Time {FS(1)} = 14,
IT = {5}.
In the second iteration, second step, we may notice
that predecessor of last task coming from IG(1) is
included in Final Set, FS(2). The situation results in
connecting both groups under holding additional
conditions:
Side{IG(1)} = Side{FS(2)},
Time + time < cycle.
After all, there is no more IT tasks, hence,
preliminary process of creating final set is
terminated.
The presented method for finding task groups is to
be summarized in simplified algorithm form. Let U
denote to be the set of un – assigned tasks yet and
TWO-SIDED ASSEMBLY LINE - Estimation of Final Results
233
IG
i
be a task group consisting of task i and all its
predecessors (excluded from U set).
STEP 1. If U = empty, go to step 5, otherwise,
assign starting task from U.
STEP 2. Identify IG
i
. Check if it contains tasks with
both left and right preference operation direction,
then remove task i.
STEP 3. Assign operation direction Side{ IG
i
} of
group IG
i
. If IG
i
has R-task (L-task ), set the
operation direction to right (left). Otherwise, apply
so called direction rules DR.
STEP 4. If the last task i in IG
i
is completed within
cycle time, the IG
i
is added to Final set of
candidates FS(i). Otherwise, exclude task i from IG
i
and go to step 1.
STEP 5. For every task group in FS(i), remove it
from FS if it is contained within another task group
of FS.
The resulting task groups become candidates for the
mated-station.
FS = {(1,4), (2,3,5,8)}.
3.2 Groups Assignment
The candidates are produced by procedures
presented in the previous section, which claim to not
violate precedence, operation direction restrictions,
and what’s more it exerts on groups to be completed
within preliminary determined cycle time. Though,
all of candidates may be assigned equally, the only
one group may be chosen. Which group it will be –
for this purpose the rules helpful in making decision,
will be defined and explained below:
AR 1. Choose the task group FS(i) that may start at
the earliest time.
AR 2. Choose the task group FS(i) that involves the
minimum delay.
AR 3. Choose the task group FS(i) that has the
maximum processing time.
In theory, for better understanding, we will consider
a left and right side of mated – station, with some
tasks already allocated to both sides. In order to
achieve well balanced station, the AR 1 is applied,
cause the unbalanced station is stated as the one
which would probably involve more delay in future
assignment. This is the reason, why minimization
number of stations is not the only goal, there are also
indirect ones, such as reduction of unavoidable
delay. This rule gives higher priority to the station,
where less tasks are allocated. If ties occurs, the AR
2 is executed, which chooses the group with the least
amount of delay among the considered ones. This
rule may also result in tie. The last one, points at
relating work within individual station group by
choosing group of task with highest processing time.
For the third rule the tie situation is impossible to
obtain, because of random selection of tasks. The
implementation of above rules is strict and easy
except the second one. Shortly speaking, second rule
is based on the test, which checks each task
consecutively, coming from candidates group FS(i)
– in order to see if one of its predecessors have
already been allocated to station. If it has, the
difference between starting time of considered task
and finished time of its predecessor allocated to
companion station is calculated. The result should be
positive, otherwise time delay occurs.
3.3 Final Procedures
Having rules for initial grouping and assigning tasks
described in previous sections, we may proceed to
formulate formal procedure of solving two – sided
assembly line balancing problem (Kim et. al, 2005).
Let us denote companion stations as j and j’,
D(i) – the amount of delay,
Time(i) – total processing time (Time{FS(i)}),
S(j) – start time at station j,
STEP 1. Set up j = 1, j’ = j + 1, S(j) = S(j’) = 0, U –
the set of tasks to be assigned.
STEP 2. Start procedure of group creating (3.2),
which identifies
FS = {FS(1), FS(2), …, FS(n)}. If FS = , go to
step 6.
STEP 3. For every FS(i), i = 1,2, … , n – compute
D(i) and Time(i).
STEP 4. Identify one task group FS(i), using AR
rules in Section 3.3
STEP 5. Assign FS(i) to a station j (j’) according to
its operation direction, and update S(j) = S(j) +
Time(i) + D(i). U = U – {FS(i)}, and go to STEP 2.
STEP 6. If U
, set j = j’ + 1, j’ = j + 1, S(j) =
S(j’) = 0, and go to STEP 2, Otherwise, stop the
procedure.
4 MEASURES OF FINAL
RESULTS OF ASSEMBLY LINE
BALANCING PROBLEM
Some measures of solution quality have appeared in
line balancing problem. Below are presented three of
them (Scholl, 1998).
Line efficiency (LE) shows the percentage
utilization of the line. It is expressed as ratio of total
station time to the cycle time multiplied by the
number of workstations:
ICINCO 2008 - International Conference on Informatics in Control, Automation and Robotics
234
where:
K - total number of workstations,
c - cycle time.
Smoothness index (SI) describes relative
smoothness for a given assembly line balance.
Perfect balance is indicated by smoothness index 0.
This index is calculated in the following manner:
where:
ST
max
= maximum station time (in most cases
cycle time),
ST
i
= station time of station i.
Time of the line (LT) describes the period of
time which is need for the product to be completed
on an assembly line
:
where:
c - cycle time,
K -total number of workstations.
5 NUMERICAL RESULTS
The results of proposed procedure for the example
from Figure 2 are given in a Gantt chart – Figure 3.
Before presenting performance measures for current
example, it would be like to stress difference in
estimation of line time form, resulting from
restrictions of parallel stations. In two – sided line
method within one mated-station, tasks are intended
to perform its operations at the same time, as it is
shown in example in Figure.3, where tasks 7, 11
respectively are processed simultaneously on single
station 3 and 4, in contrary to one – sided heuristic
methods. Hence, modification has to be introduced
to that particular parameter which is the
consequence of parallelism. Having two mated-
stations from Figure 3, the line time LT is not 3*16
+ 13, as it was in original expression. We must treat
those stations as two double ones (mated-stations),
rather than individual ones S
k
. Accepting this line of
reasoning, new formula is presented below:
where:
Km – number of mated-stations
K – number of assigned single stations
t(S
K
) – processing time of the last single
station
Figure 3: Results for the example problem.
As far as smoothness index and line efficiency are
concerned, its estimation, on contrary to LT, is
performed without any change to original version.
These criterions simply refer to each individual
station, despite of parallel character of the method.
But for more detailed information about the balance
of right or left side of the assembly line additional
measures will be proposed:
Smoothness index of the left side
where:
SI
L
- smoothness index of the left side of two-sided
line
ST
maxL
- maximum of duration time of left allocated
stations
ST
iL
- duration time of i-th left allocated station
Smoothness index of the right side
100%
K
c
ST
LE
K
1i
i
=
=
(1)
()
=
=
K
1i
2
imax
STSTSI
(2)
()
K
T1KcLT +=
(3)
() }{
)t(S),t(SMax1KmcLT
1KK
+=
(4)
()
=
=
K
1i
2
iLmaxLL
STSTSI
(5)
TWO-SIDED ASSEMBLY LINE - Estimation of Final Results
235
where:
SI
R
- smoothness index of the right side of two-sided
line
ST
maxR
- maximum of duration time of right allocated
stations
ST
iR
- duration time of i-th right allocated station
Table 1: Numerical results.
Name Value
LE 84,38%
LT 30
SI 4,69
SI
R
2
SI
L
3
The numerical results of different measures in Table
1 are given. The value of line efficiency is
acceptable, smoothness indexes of the right and left
side of the line show which part of the assembly line
is better balanced. The smoothness index SI informs
about balance of the whole line. It is possible to
compare the two-sided line balance with single
assembly line balance and to consider the influence
of position restrictions (L,R or E).
Next it will be consider a small example
presented in Figure 4.
Figure 4: Precedence graph (4 tasks, c=10).
In this point, it’s worth to mention about a special
case, when mated-station includes instead of two
stations, just one. Such a situation takes place, where
one station is loaded to a certain point that not
allows for assigning any more tasks for this part of
the line. As the result, one station stays empty.
Balance of this case is presented in Figure 5.
Figure 5: Balance of two-sided line (N=4, c=10).
In this case we got an assembly line which is a structure of
incomplete two-sided assembly line. It is possible to
estimate the balanced line in two ways: as a single line
with parallel stations or incomplete two-sided line.
In the first case we obtain:
K = 3
LE = 46,67%
SI = 9,9
Considering this case as two-sided line we get:
K = 4
LE = 35%
SI
R
= 11,18
SI
L
= 8,54
SI = 14,07
As we can see there are some differences in final
measurements of the balanced line. The reason is
that using heuristic methods we design two-sided
assembly line. These kinds of heuristics are very
sensitive to cycle time value. Some final balances
for different value of cycle time for an example from
Figure 2 in Table 2 are shown.
Table 2: Final results of different measures (c = var).
c K LT SI LE
14 6 37 15,81 66,67%
15 6 39 17,66 62,22%
16 4 30 4,69 84,38%
17 6 43 22,05 54,90%
18 4 32 4,69 77,70%
()
=
=
K
1i
2
iRmaxRR
STSTSI
(6)
4
1
0
TATI
1
10
STATION 2
12
7
10
10
STATION 4
3
4
5
ICINCO 2008 - International Conference on Informatics in Control, Automation and Robotics
236
6 CONCLUSIONS
Two-sided assembly lines become more popular in
last time. Therefore it is obvious to consider this
structure using different methods. In this paper a
heuristic approach was discussed. Two-sided
assembly line structure is very sensitive to changes
of cycle time values. It is possible very often to get
incomplete structure of the two-sided assembly line
(some stations are missing) in final result. We can
use different measures for comparing the solutions
(line time, line efficiency, smoothness index).
Author proposes additionally two measures:
smoothness index of the left side (SI
L
) and
smoothness index of the right side (SI
R
) of the two-
sided assembly line structure. These measurements
allow to get more knowledge about allocation of the
tasks and about the balance on both sides.
This research was supported by grant of Ministry
of Science and Higher Education 3T11Ao2229 in
2005-2008.
REFERENCES
Bartholdi J.J., 1993. Balancing two-sided assembly lines:
a case study, International Journal of Production
Research, 23, 403-421
Baybars, I., 1986. A survey of exact algorithms for simple
assembly line balancing problem, Management
Science, 32, 11-17
Eral, Erdal, Sarin S.C., 1998. A survey of the assembly
line balancing procedures, Production Planning and
Control, 9, 34-42
Forteca D.J., Guest C.L., Elam M., Karr C.L., 2005. A
fuzzy logic approach to assembly line balancing,
Mathare & Soft Computing, 57-74
Gutjahr, A.L., Neumhauser G.L., 1964, An algorithm for
the balancing problem, Management Science, 11, 23-
35
Halgeson W. B., Birnie D. P., 1961. Assembly line
balancing using the ranked positional weighting
technique, Journal of Industrial Engineering, 12, 18-
27
Kao, E.P.C., 1976. A preference order dynamic program
for stochastic assembly line balancing, Management
Science, 22, 19-24
Lee, T.O., Kim Y., Kim Y.K., 2005. Two-sided assembly
line balancing to maximize work relatedness and
slackness, Computers & Industrial Engineering, 40,
273-292
Salveson, M.E., 1955. The assembly line balancing
problem, Journal of Industrial Engineering, 62-69
Scholl, A., 1998. Balancing and sequencing of assembly
line, Physica- Verlag
Sury, R.J., 1971. Aspects of assembly line balancing,
International Journal of Production Research, 9, 8-14
TWO-SIDED ASSEMBLY LINE - Estimation of Final Results
237
