its affiliated organizations, local governments, public
ordering agencies, and construction companies [2].
MOLIT requires a review of the design VE during the
basic and working design stages for public
construction projects with a minimum total project
cost of 10 billion won, in accordance with the
"Enforcement Guideline for the Review of the
Economic Efficiency of Designs, Etc." Furthermore,
the results of the design VE are registered and
managed through the Design VE Madang in the
Construction Project Information Portal System, and
the design VE information is shared among the
MOLIT-affiliated organizations, local governments,
public ordering agencies, and construction-related
organizations. The design VE information is limited,
however, because it contains only the ideas and
improvements in the basic and working design stages
as well as summarized information regarding cost-
saving practices. The MOLIT-affiliated
organizations, such as corporations and industrial
complexes, are sharing information by publishing
their collections of cost-saving practices in the
planning, design, and construction stages. The
regional construction and management offices,
however, which are affiliated with MOLIT, are not
yet publishing or sharing their cost-saving practices.
2.2 Investigation and Analysis of the
Current Research Trends
The studies on the cost-saving practices of
construction projects have been mostly about the
application cases of design VE and the improvement
of the construction and engineering methods. Other
studies include those on the cost management and
saving methods for unit constructions as well as on
the construction types, cost-saving methods through
schedule management, and analysis of the factors
influencing the construction cost.
The analysis of the current research trends
revealed that there have been few studies on the cost-
saving practice information sharing and service
methods for improving the efficiency of public
construction projects. Therefore, research on
information sharing and service is required for the
integrated and systematic management and utilization
of cost-saving practices in the execution of public
construction projects in the future.
2.3 Analysis of Cases of FMMS-based
Bridge Inspection and Analysis
FMMS’s inspection and diagnosis menu consists of
planning in line with the above workflow,
management of the inspection history, inquiry about
the damage photos by member and about the maps of
damages by visual inspection, internal approval, and
confirmation of the inspection book. Fig. 1 shows
cases of the history of inspection and diagnosis.

3 INFORMATION SYSTEM
DEVELOPMENT AND
SERVICE METHODS
In this study, to develop a cost-saving practice
information system for construction projects, the
design changes, design standards, and operation
process revisions were analyzed based on the
"Collection of Expressway Design Work Practices"
published by Korea Expressway Corporation.
Furthermore, a database (DB) of cost-saving practices
and original data such as project outlines, status,
problems, improvements, and conclusions with
regard to construction cost-saving practices was
constructed through the preparation of metadata [2].
The construction project cost-saving practice DB
was designed to consist of four major types of
information: “cost-saving practices”, “cost-saving
practice application details”, “cost-saving practice
utilization plans”, and “cost-saving practice common
codes”. The cost-saving practice information includes
the general status information of construction
projects, including the project outlines. The cost-
saving practice application details consist in the
processing status and the results of requests for cost-
saving practices in public ordering agencies and
construction companies. The cost-saving practice
utilization plans allow the entry of a detailed
utilization plan to view or download cost-saving
practice information or attached files. The cost-saving
practice common codes define classification names,
classification types, and codes according to the
integrated construction information classification
system to improve the search and view convenience.

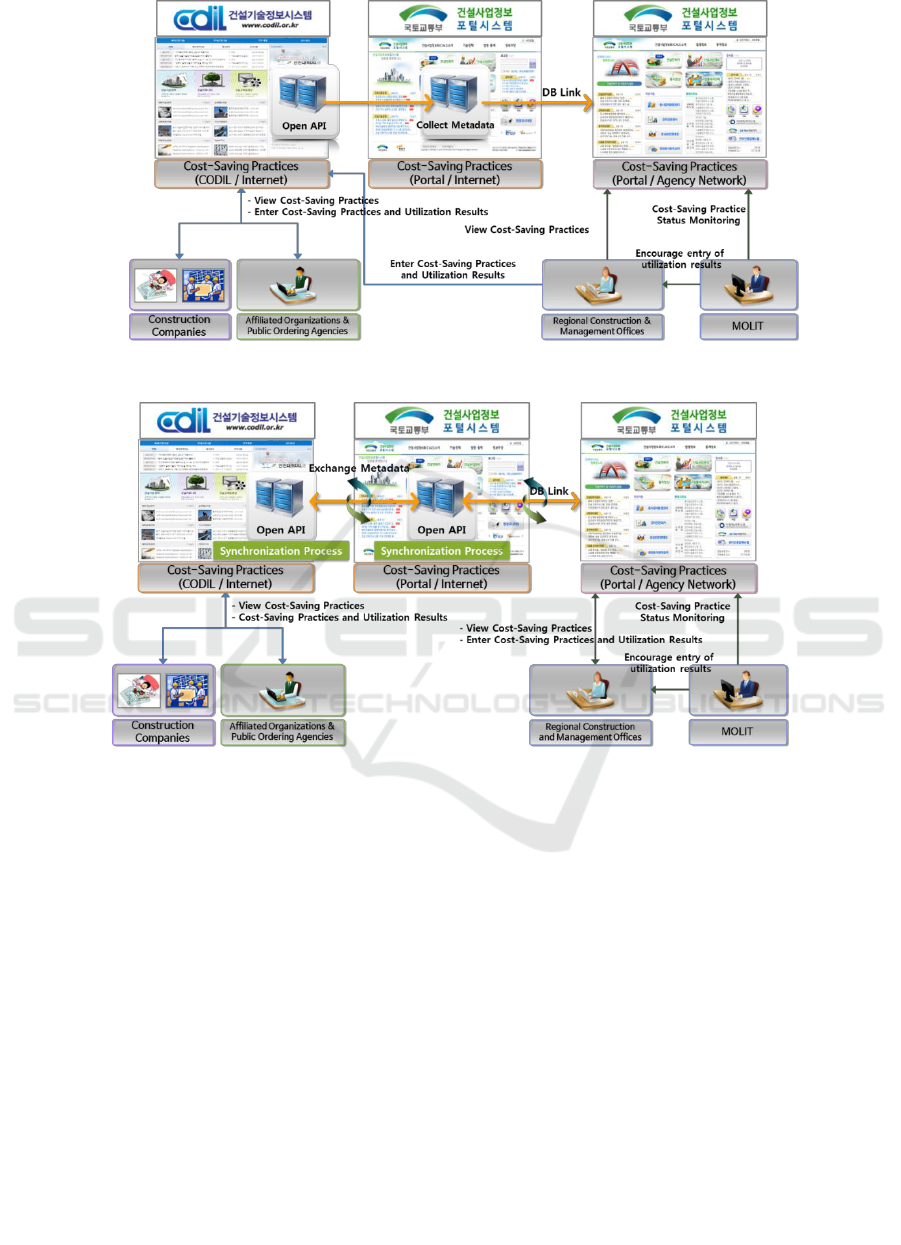

In this study, a step-by-step information system
development method was prepared for the utilization
and integrated management of cost-saving practice
information in the future by MOLIT and the regional
construction and management offices.
First, the construction project cost-saving practice
information system was set up in such a way that it
can be serviced from CODIL (Construction
Technology Digital Library), which corresponds to a
unit system of the Construction Project Information
System, one of MOLIT’s operation systems. CODIL
is easily accessible by the MOLIT-affiliated
A Study on the Public Construction Project Cost-Saving Practice Information Provision Service Method
249
