A Risk Management Framework for Scrum Projects
Samuel de Souza Lopes
1 a
, Rog
´
eria Cristiane Grat
˜
ao de Souza
2 b
, Allan de Godoi Contessoto
2 c
,
Andr
´
e Luiz de Oliveira
3 d
and Rosana Teresinha Vaccare Braga
1 e
1
Institute of Mathematical and Computer Sciences, University of S
˜
ao Paulo, S
˜
ao Carlos-SP, Brazil
2
Department of Computer Science and Statistics, S
˜
ao Paulo State University, S
˜
ao Jos
´
e do Rio Preto-SP, Brazil
3
Department of Computer Science, Federal University of Juiz de Fora, Juiz de Fora-MG, Brazil
Keywords:
Agile Software Development, Scrum, Product Owner, Project Management, Risk Management.
Abstract:
Software changes constantly to suit the market volatility, causing risks to the project. Agile software develop-
ment approaches, such as Scrum, have been proposed to deal with constant changes in project requirements.
In Scrum, the Product Owner (PO) is responsible for managing such changes and ensuring that the developed
software brings significant value to the customers. However, there are potential risks involved in these respon-
sibilities. If not properly managed, they can lead to project failure. In this paper, we introduce a novel approach
to managing risks involving PO’s roles. In our work, we tailored the risk management knowledge area from
the Project Management Body of Knowledge Guide into the Scrum. We established a framework called RIsk
Management PRoduct Owner (RIMPRO), which intends to support project teams to systematically manage
risks related to PO activities that may arise during the project. As proof of concept, the processes described in
RIMPRO were evaluated by potential users. Through a preliminary assessment, we observed that RIMPRO is
promising since it can assist teams in managing risks involving PO in a systematized and effective manner.
1 INTRODUCTION
The traditional waterfall process for software de-
velopment has been criticized and characterized by
disconnecting important life-cycle activities, such as
planning, analysis, design, implementation, and test-
ing. A waterfall life-cycle is also characterized by
having unpredictable schedules and slower transitions
between activities, which may increase project costs.
Moreover, there is a risk that the delivered software
at the end of a waterfall life-cycle does not meet
the customer’s expectations since emergent require-
ments identified after analysis could not be consid-
ered throughout the software development process. In
the view of this scenario, agile process models (e.g.,
Scrum) and practices, such as ”release early” and ”re-
lease often”, are well established in open source soft-
ware development and address the limitations of the
waterfall model (Sutherland and Sutherland, 2014).
a
https://orcid.org/0000-0003-1721-311X
b
https://orcid.org/0000-0002-7449-9022
c
https://orcid.org/0000-0001-6545-5178
d
https://orcid.org/0000-0003-0564-0034
e
https://orcid.org/0000-0003-4259-0785
Despite the benefits of agile methods regarding
evolution and self-adaptiveness, they were viewed
with scepticism for their emphasis on contrary ideas
of the traditional software engineering, such as scarce
software documentation and prioritization of project
changes (Dingsøyr et al., 2012). The uncertainty
and active participation of stakeholders on projects
contributed to the adoption of agile methods. How-
ever, risk management has been neglected or partially
supported in agile methods like Scrum, even with
risk management gaining importance among organi-
zations, since risks may arise throughout the life cy-
cle of the project (de Godoi Contessoto et al., 2016;
Tavares et al., 2019b). In Scrum, the Product Owner
(PO) has a major role in defining the requirements to
address customer needs and leading the project, but
this is also risky as risks regarding its roles may arise
throughout the project, then they should be properly
managed. Therefore, it is important to incorporate
traditional risk management approaches within ag-
ile methods (Gold and Vassell, 2015; Tavares et al.,
2019b).
In this paper, we introduce a novel approach to
managing risks involving PO’s roles. A framework
called RIsk Management PRoduct Owner (RIMPRO)
30
Lopes, S., Gratão de Souza, R., Contessoto, A., Luiz de Oliveira, A. and Braga, R.
A Risk Management Framework for Scrum Projects.
DOI: 10.5220/0010448300300040
In Proceedings of the 23rd International Conference on Enterprise Information Systems (ICEIS 2021) - Volume 2, pages 30-40
ISBN: 978-989-758-509-8
Copyright
c
2021 by SCITEPRESS Science and Technology Publications, Lda. All r ights reserved
has been established to assist the management of such
risks in the context of Scrum. As proof of concept,
the processes described in RIMPRO were evaluated
by potential users. We also present a classification
intended to guide RIMPRO users to classify PO risks.
The remainder of this paper is organized as fol-
lows. Section 2 introduces the required background
for the reader to understand the work contributions.
Section 3 presents the RIMPRO and its processes.
Section 4 presents the results obtained through RIM-
PRO assessment. Section 5 discusses the related
works. Finally, Section 6 presents the conclusions and
proposals for future work.
2 BACKGROUND
Scrum is an agile method for project management
with an emphasis on software development projects.
Scrum is not characterized as a methodology, but as
a framework, since it is possible to employ various
processes or techniques (Sutherland and Sutherland,
2014). Scrum emphasizes incremental software de-
velopment. The set of all requirements of the software
is called Product Backlog as well as the set of imple-
mented requirements in each Sprint is called Sprint
Backlog. An increment is delivered to customers at
the end of each iteration (Sprint). Scrum is an adap-
tive and self-corrective approach for reviewing the in-
crements implemented in each Sprint and checking
possible improvements in the processes used to man-
age the project in the Sprint Review and Sprint Retro-
spective meetings, respectively. Scrum is one of the
most agile methods adopted in the industry. However,
it does not provide support for formal risk manage-
ment that embraces the main processes, such as plan-
ning, analysis, and risk response planning (Tavares

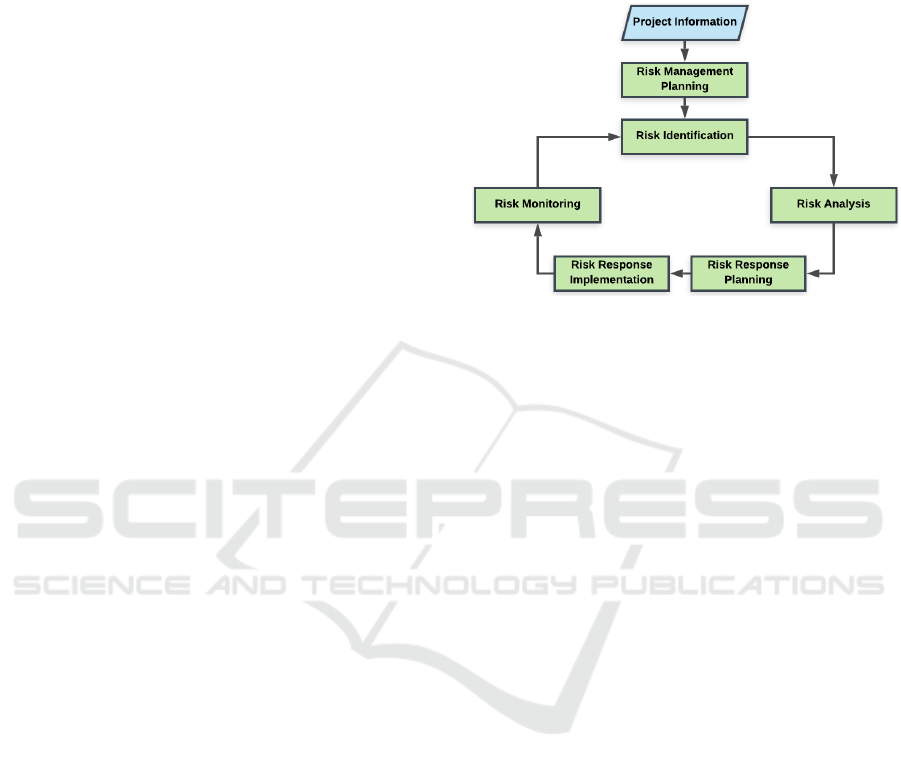

et al., 2019b).
Risk management is a set of processes for iden-
tifying and controlling areas or events that have the
potential of causing unwanted changes. The Project
Management Body of Knowledge (PMBoK) Guide
defines risk management as a set of seven pro-
cesses: Plan Risk Management; Identify Risks; Per-
form Qualitative Risk Analysis; Perform Quantitative
Risk Analysis; Plan Risk Responses; Implement Risk
Responses; and Monitor Risks. Due to the lack of
standardization of the term ”risk”, we have used the
definition proposed by PMBoK. Risk is an ”event or
an uncertain condition that, if it occurs, can result in
positive (opportunities) or negative impacts (threats)
in one or more project objectives, such as scope, time,
cost, and quality” (PMI, 2017).
In agile project management, due to the recep-
tivity to changes, several projects have uncertainties
and risks. To ensure that risks are well understood
and treated, projects managed through adaptive ap-
proaches make use of frequent reviews of work prod-
ucts and multi-functional project teams to accelerate
communication and knowledge sharing. These risks
can be managed through traditional risk management
processes, as long as they are adapted to the context
of agile development (Andrat and Jaswal, 2015; Al-
liance, 2017).
Eventually, several risks remain unknown because
they are ignored throughout the project life-cycle.
Thus, it is needed to introduce risk management pro-
cesses within agile development (Andrat and Jaswal,
2015). In this context, the Project Management Insti-
tute (PMI), together with the Agile Alliance, devel-
oped the Agile Practice Guide. This guide provides
tools, situational guidance, and an understanding of
the various agile approaches available to enable bet-
ter results throughout the project. The Agile Prac-
tice Guide assists traditional project teams that want
to apply agile development concepts to their projects.
Even helping traditional teams adopt agile practices,
the Agile Practices Guide does not support changes
or modifications to PMBoK processes or knowledge
areas, such as risk management, justifying the impor-
tance of this work (Alliance, 2017).
The PO plays an essential role throughout the
project life-cycle, with the responsibility of managing
requirements and ensuring that the software brings
significant value to customers. Due to her/his impor-
tance in the project, the risk identification and anal-
ysis associated with PO decisions are needed. The
previous knowledge of these risks may contribute to
the success of the project (Sutherland and Sutherland,
2014). From the current literature analysis, we can
group the potential risks involving the PO decisions
into three groups described as follows.
2.1 Requirements Engineering Risks
(Dikert et al., 2016) point out that several risks may
arise if the PO does not correctly perform his/her du-
ties in the requirements engineering stage, therefore
it is necessary to document and analyze such risks.
The risks involving the PO are broken down into four
categories:
Risks Related to Lack of Requirements Docu-
mentation: The production of lean documenta-
tion is one of the main problems in agile develop-
ment processes. Traditional requirements specifi-
cation are replaced with stories or backlog items
to document the potential interactions of stake-
holders with software (Sutherland and Suther-
A Risk Management Framework for Scrum Projects
31
land, 2014). The most effective way to min-
imize the problems related to lean documenta-
tion is through efficient communication since the
main problems exposed by the literature related to
lean documentation occur due to inefficient com-
munication between the Scrum Team and cus-
tomers (Inayat et al., 2015; Curcio et al., 2018;
Elghariani and Kama, 2016; Fitriani et al., 2016).
However, communication failures can also arise
when all Scrum Team members are not accommo-
dated in the same work environment because it is
more difficult to communicate changes in require-
ments among Scrum Team members and cus-
tomers. Thus, the use of more detailed user stories
facilitates homogeneous communication between
stakeholders, helping developers to make correct
choices regarding the implementation of an incre-
ment during a Sprint (Inayat et al., 2015; Elghari-
ani and Kama, 2016);
Risks Related to Lack of Customers to Take
Decisions: One of the pillars of the Agile Mani-
festo is the customer’s interaction with the project
team, which is disseminated in several agile ap-
proaches, such as Scrum. Since the PO is respon-
sible for ensuring that the increments have signif-
icant value to the customer, it is up to her/him
to maintain constant contact with the customer
(Sutherland and Sutherland, 2014). Customer
availability is important, as changes in require-
ments being determined directly by the customer
can speed up the project, as well as to prioritize
requirements by customers creates higher value
increments. However, the client’s unavailability
in taking project decisions is a problem since the
continuous contact with the Scrum Team gener-
ates costs for the organization that requested the
software (Inayat et al., 2015; Curcio et al., 2018;
Elghariani and Kama, 2016). A way to solve this
problem in practice is assigning customer role to
one member of the Scrum team. It may con-
tribute to reducing the need for constant interac-
tion with real customers. However, such an ap-
proach is only effective when the Scrum team
members have substantial knowledge of the tar-
geted application domain (Inayat et al., 2015).
Another issue related to the client is the lack of
knowledge to define the requirements. This is-
sue also occurs in projects as there is more than
one client, making it difficult to reach a consensus
among the group when there are disagreements
regarding requirements. That is more evident in
projects with shorter Sprints. If this problem oc-
curs, the project’s performance is directly affected
(Inayat et al., 2015; Curcio et al., 2018);
Risks Related to Changes in the Requirements:
The lack of clarity in the definition of the re-
quirements can contribute to project failures, as
it impairs the product overview (Alliance, 2017;
Sutherland and Sutherland, 2014). To developing
increments with significant value to customers, re-
quirements must be documented, prioritized, and,
if needed, modified (Inayat et al., 2015; Elghar-
iani and Kama, 2016; Fitriani et al., 2016). The
requirements definition process may be compli-
cated, as stakeholders often have different expec-
tations of a requirement. Also, the requirements
suggested by some stakeholders may be consid-
ered unworkable by the Scrum Team. Another ob-
stacle is when the client considers that most of the
software requirements are mandatory and equally
important, so it is difficult to use criteria for prior-
itizing these requirements (Elghariani and Kama,
2016; Alliance, 2017);
Risks Related to Budget, Architecture, and
Schedule: Analogously to traditional software
development approaches, the design of the soft-
ware architecture, the estimation of project bud-
get, and the management of the schedule are criti-
cal activities for organizations adopting Scrum in
their projects. That occurs because, in Scrum, re-
quirements are considered volatile since they may
change throughout the project (Inayat et al., 2015;
Elghariani and Kama, 2016; Curcio et al., 2018).
To reduce the time and effort needed to turn re-
quirements into increments, the requirement can
be decomposed into smaller sub-requirements.
Requirements decomposition may contribute to
improving the accuracy of schedule estimation
and minimizing the occurrence of unforeseen
events during the Sprint (Alliance, 2017).
2.2 Software Quality Risks
(Asghar et al., 2017) emphasize that the lack of
quality and clarity of requirements can contribute to
project failures. On the other hand, (Dikert et al.,
2016) point out that the quality control functions as-
signed to Scrum Team members may be adversely af-
fected when ambiguous requirements arise. To avoid
ambiguities, the PO can receive specialized training,
so that the Scrum Team can establish a structured way
to document the requirements.
2.3 Risks Related to Migration of
Traditional Teams to Agile
These risks are related to the inherent insertion of ag-
ile approaches characteristics in the context of teams
ICEIS 2021 - 23rd International Conference on Enterprise Information Systems
32
that use traditional techniques of software engineer-
ing (Gandomani and Nafchi, 2016). The Agile Prac-
tice Guide provides guidance to support traditional
teams to adapt their practices to the agile context (Al-
liance, 2017). Such adaptation requires sufficient time
and effort, but risks can often arise during this change
(Gandomani and Nafchi, 2016). So, a risk may or
not be related to migration. Even after the migration,
risks related to Requirements Engineering (RE) and
Software Quality (SQ) can occur, as they are activ-
ities inherent to the PO. Thus, the risk can receive
more than one classification if it is related to one of
the functions of the PO (RE and SQ) and, also, the
project team is migrating to Scrum.
In this scenario, we can conclude that the PO has
great importance since (s)he is a member of the Scrum
Team responsible for crucial stages of the project.
Consequently, risks can arise involving her/his deci-
sions throughout the project. The risks related to agile
methods, such as Scrum, are scarce, unlike the tradi-
tional software development approaches in which the
risks are well-known (Andrat and Jaswal, 2015). This
leads us to believe that the use of an adapted risk man-
agement framework to the Scrum context, focusing on
the risks involving the PO, is important to support the
documentation of risk analysis and mitigation mea-
sures in agile projects. Lessons learned from projects
can provide support for decision making by software
organizations that use Scrum to manage their projects.
For this purpose, such framework should support the
classic processes of risk management, such as iden-
tification, analysis, and planning of responses to pos-
itive and negative risks of the project adapted to the
agile context (Tavares et al., 2019b).
3 RISK MANAGEMENT
PRODUCT OWNER (RIMPRO)
RIMPRO is a framework that proposes a modification
of the risk management processes exposed in PMBoK
to managing risks involving PO. In this context, RIM-
PRO intends to guide traditional teams that need to
adopt agile practices in their projects. This is quite
common currently so that such teams can combine
concepts proposed by Scrum with the structured risk
management of RIMPRO, using concepts proposed
by the Agile Practice Guide (Alliance, 2017). We
consider RIMPRO is a framework instead of a process
because each team is free to adapt it according to their
needs. We use the word ”process” to define risk man-
agement steps to maintain the PMBoK nomenclature
standard.
As shown in Figure 1, project information, such
as budget, schedule, and stakeholders, is needed to
guide the structure established for RIMPRO, which
foresees the execution of six processes, described in
the following subsections.
Figure 1: Relationship between RIMPRO processes.
Comparing the structure of RIMPRO with risk man-
agement processes established by PMBoK, we ob-
served that Quantitative Risk Analysis provided by
PMBoK is not performed due to insufficient numeri-
cal data on the identified risks by RIMPRO to carry
out such process, considering its agile focus (Al-
liance, 2017).
For the correct application of RIMPRO, all stake-
holders must participate in the proposed processes be-
cause the knowledge of them must be gathered dur-
ing the execution of the risk management processes
(Siqueira et al., 2017). Moreover, as risks that involve
PO can arise throughout the project, the processes
foreseen by RIMPRO must be iteratively executed on
all Sprints. Thus, we emphasize that all the documen-
tation provided by the framework must be created or
reviewed in a Sprint. The documents generated or up-
dated through the RIMPRO processes are Risk Man-
agement Plan which describes how risk manage-
ment processes are structured and executed; Project
Risk Backlog which reports all risks identified for
the project; Sprint Risk Backlog which reports all
monitored risks of a particular Sprint in which each
Sprint has its Sprint Risk Backlog.
3.1 Risk Management Planning
Risk Management Planning is the process of defining
how RIMPRO project risk management is conducted
to ensure that the degree, type, and visibility of risk
management are proportional to the risks and the im-
portance of the project to the organization and other
stakeholders (Alliance, 2017). This process must be
performed at the beginning of the project, before the
A Risk Management Framework for Scrum Projects
33
first Sprint Planning Meeting, because while the PO
performs functions throughout the entire project, risks
associated with (s)he may arise. Thus, it is necessary
to begin risk management before the beginning of the
first Sprint (Sutherland and Sutherland, 2014).
At the beginning of the project, key definitions
are established, such as the individual responsible for
project risk management. This individual, namely
Risk Master, must ensure that all Scrum Team mem-
bers are performing the risk management processes
foreseen by RIMPRO, as well as managing the plan-
ning documents. As this framework aims at risk man-
agement involving PO, Risk Master should be repre-
sented by the PO itself for two main reasons: i) the
PO is the most important member of the Scrum Team
for risk management (Tavares et al., 2019a); ii) and
the risks can be related to the client and the PO is the
most suitable member to treat them, since (s)he is the
one that has direct contact with the client throughout
the project among the other members of the Scrum
Team (Sutherland and Sutherland, 2014).
In addition to the Risk Master definition, other
definitions must be taken, namely (PMI, 2017):
Roles and Responsibilities: As risk management
is a vital process for the success of the project
and the Scrum Team is a self-managed team
that shares all the knowledge acquired among its
members, everyone must participate in the man-
agement processes of risks, as this ensures trans-
parency of project information among stakehold-
ers (Sutherland and Sutherland, 2014);
Deadlines: It defines when and how often the
risk management processes will be carried out
throughout the life cycle of the project and estab-
lish the protocols for applying the contingency re-
serves in the schedule;
Stakeholder Risk Appetite: It is the maximum
amount or volume of risks that stakeholders are
willing to tolerate, called the maximum overall
risk level of the project, to be expressed as lim-
its of measurable risks for each project objective.
As the project is divided into Sprints, the overall
risk level of the project must be updated with each
Sprint;
Budget: It estimates funds based on designated
resources for inclusion in the cost baseline, and
establishes protocols for applying contingency
and management reserves.
At the end of the process, all agreed definitions should
be contained in the Risk Management Plan. For
Sprint’s goal not to be degenerate, changes to the
Risk Management Plan must be requested during the
Sprint Retrospective, as this meeting makes adjust-
ments to Scrum Team to improve its work (Sutherland
and Sutherland, 2014).
3.2 Risk Identification
In this process, risks are identified and their charac-
teristics are documented. All stakeholders, including
customers, should be encouraged to suggest new risks
at any time. This process must be continuous because
the project is susceptible to uncertainties throughout
its life cycle, so risks can be identified at any time
(Alliance, 2017). To support the Scrum Team and,
specifically, the Risk Master, risks related to PO’s
roles succinctly described in Section 2 are listed and
made available. The risks identified are documented
with the following attributes:
Risk Title: Short description of the risk;
Owner: If the risk materializes, the owner is a
member of the Scrum Team or an external or-
ganization. If the implementation of the risk re-
sponse is outsourced, the owner should be the en-
tity responsible for applying one of the agreed re-
sponses;
Date of Registration: Date on which the risk was
registered;
Type: Opportunity or Threat;
Classification: According to the analysis exposed
in Section 2, PO’s risks may be classified into
three ways: Requirements; Software Quality;
and Migration to Scrum. When the risk does not
meet any of the classifications suggested above, it
may be defined as Not defined;
Sprint Affected: It determines the Sprint that can
be affected if the risk materializes;
Probability of Occurrence: It is a float value
between zero and one, the higher the value, the
greater the probability of the risk to occur. This
value must be refined in the Risk Analysis pro-
cess;
Impact: It is a float value between zero and one,
the higher the value, the greater the positive im-
pact, in the case of opportunity, or negative, in the
case of a threat, of the risk. This value must be
refined in the Risk Analysis process;
General Description: To avoid ambiguities, the
following structure should be used to describe the
risks identified using the risk specifications: If a
CAUSE exists, the EVENT may occur, leading to
the EFFECT;
ICEIS 2021 - 23rd International Conference on Enterprise Information Systems
34
Main Causes: They must be evident, as they can
cause one or more identified risks. These causes
must be registered to support the future identifica-
tion of risks for this and other projects;
Potential Responses: During the Risk Identifica-
tion process, some potential responses to the iden-
tified risks can be developed. These responses
will be improved in the Risk Response Planning
process;
Triggers: Events or conditions that indicate that
the risk is about to occur.
The risks present in the Project Risk Backlog will be
further analyzed in the subsequent process.
3.3 Risk Analysis
In this process, the risks are analyzed and the Project
Risk Backlog is updated for additional action. This
analysis is done only in a qualitative way, due to in-
sufficient data to perform a quantitative analysis (Al-
liance, 2017). As the purpose of this process is to
prioritize the risks that will be monitored during the
Sprint, the risk analysis must be done during Sprint
Planning because in this meeting the Sprint goals are
defined (Sutherland and Sutherland, 2014).
Therefore, the risks are analyzed through a tech-
nique proposed in this work, called Risk Plan-
ning Poker, in which Planning Poker is adapted to
risk management (Sutherland and Sutherland, 2014).
Based on the Delphi technique which is used to
reach consensus among experts while preserving their
anonymity (Dalkey and Helmer, 1963), the risk anal-
ysis is performed anonymously among Scrum Team
members (Alliance, 2017). Risk Planning Poker is di-
vided into two steps.
In Step 1, Scrum Team members empirically
choose the risks that can affect the Sprint. These risks
will be analyzed in Risk Planning Poker, in which
each member has a deck. Each card contains a Fi-
bonacci sequence number, as the human mind has dif-
ficulty perceiving faint changes. Thus, the distance
between the numbers in this sequence is sufficient for
the difference between the probabilities of occurrence
or the impacts of the risks to be perceived more easily,
intuitively. At each round, the probability of occur-
rence of risk is analyzed, with each member selecting
a card and placing its face down on the table. Each
card placed on the table represents the opinion of each
participant about the probability of occurrence of the
risk analyzed. Then all members cast their respective
cards at the same time. If all members’ opinions are
within a distance of up to two cards from each other,
the probability of occurrence of this risk is the arith-
metic mean of the card values of all members. Oth-
erwise, members who have selected the highest and
lowest card explain their reasoning. After both expla-
nations, a new round is made and the probability of
the risk analyzed is the arithmetic mean of the card
values (Sutherland and Sutherland, 2014). At the end
of all the rounds from step 1, the risks that exceed the
established limit value comprise the list of risks that
will be analyzed in step 2.
Step 2 is analogous to step 1, but the impact of the
risks that exceed the limit value of step 1 will be fur-
ther analyzed. After completing the two steps, the fa-
cilitator determines the highest probability or impact
risks that will be monitored throughout the Sprint, so
that these risks will compose the Sprint Risk Backlog.
After Risk Planning Poker, the Risk Master cre-
ates the Sprint Risk Backlog. Thus, each Sprint has
a list of risks that can affect the success of the it-
eration. Since the Scrum Team has few members,
lean documentation, and a limited budget, the Sprint
Risk Backlog should contain few risks. Therefore,
it avoids a significant increase in additional project
work (Sutherland and Sutherland, 2014).
To facilitate the monitoring of the Sprint Risk
Backlog, a probability and impact matrix should be
used (PMI, 2017). Thus, risks are normalized using
min-max normalization in which risks are normalized
to values in the range of 0 to 1 (Faceli et al., 2011).
Such scaling is performed by the equation in 1, where
risk
normalized
i
is the value of risk
i
normalized to a
value contained in the range [0, 1], risk
i
is the prob-
ability of occurrence or impact of risk
i
calculated on
Risk Planning Poker, max and min are the values of
the highest and lowest card in the deck used during
the analysis of risk
i
, respectively. For example, con-
sider that an organization uses a deck whose lowest
and highest cards range from 3 to 21, respectively. If
the probability of occurrence and the impact of a risk
is 17 and 15, respectively, then the normalized proba-
bility of occurrence and impact of this risk is 14/18 =
0.78 and 12/18 = 0.67, respectively.
After normalization, the Risk Master should de-
fine the probability and occurrence ranges for the cat-
egories (e.g. very low, low, moderate, high, and very
high) and exhibit them in a probability and impact
matrix. The responses to the risks that make up the
Sprint Risk Backlog are defined in the subsequent
process, called Risk Response Planning.
risk
normalized
i
=
risk
i
min
max min
(1)
A Risk Management Framework for Scrum Projects
35
3.4 Risk Response Planning
Risk Response Planning is the process responsible
for developing options and actions to maximize op-
portunities and minimize threats to project objectives
(Alliance, 2017). This process occurs after the Risk
Analysis process because the risks of the Sprint Risk
Backlog have already been defined, but their respec-
tive answers have not yet been elaborated.
Risk responses should be developed with the col-
laboration of all stakeholders, including customers
with knowledge in the application domain and man-
agers. Planned responses should be appropriate to the
relevance of the risk, have cost-effectiveness to meet
the challenge, be realistic within the project context,
be agreed upon by all stakeholders, and have a desig-
nated stakeholder. In general, it is necessary to select
the best response to risk among the various possible
options. The Risk Master should mediate this pro-
cess before the beginning of the Sprint because the
responses to certain risks may vary throughout the
project, i.e., risk responses for a given Sprint may
not be appropriate for subsequent Sprints (Alliance,
2017).
For each risk of the Sprint Risk Backlog, the strat-
egy or mix of response strategies of greater efficiency
should be selected, including major and secondary
strategies as needed. If the major strategies do not
take effect, the possibility of applying the secondary
strategies should be evaluated. Another point to em-
phasize is the secondary risks. For these risks, a sur-
plus may be allocated for time or cost contingencies,
as well as the identification of the conditions that trig-
ger the use of these surpluses (Alliance, 2017). At
the end of the process, the Risk Master must update
the Sprint Risk Backlog response lists and starting the
subsequent process.
3.5 Risk Response Implementation
Risk Response Implementation is the process respon-
sible for implementing the risk response plans that
compose the Sprint Risk Backlog to ensure that risk
responses are carried out as planned. Attention to this
process will ensure that the responses to the agreed
risks are implemented. A common problem with risk
management is that the Scrum Team devotes efforts
to identify and analyze risks and developing risk re-
sponses, but no action is taken to manage them (Al-
liance, 2017; Sutherland and Sutherland, 2014).
Tools and techniques can be used to the imple-
mentation of the risk response plans associated with
Sprint Risk Backlog, such as (Alliance, 2017):
Expert Opinion: It should be considered by
Scrum Team individuals with specialized knowl-
edge to validate or modifying responses to risks,
if necessary, and decide how to implement them
most efficiently;
Interpersonal and Team Skills: Among the in-
terpersonal and team skills that can be used in this
process, the main one is influence. Some risk re-
sponse actions may be owned by people outside
the Scrum Team or who have other conflicting de-
mands. It is necessary, at certain points in the
project, that the Risk Master takes influence to
encourage the appointed risk owners to take the
necessary measures when appropriate;
Project Management Information System:
May include schedule, resource, and cost software
to ensure that agreed risk response plans and their
associated activities are integrated into the project
along with other project activities.
If any response is modified during the process, the
Sprint Risk Backlog should be updated (Alliance,
2017).
3.6 Risk Monitoring
Risk Monitoring is the process responsible for: (i)
monitoring the implementation of the risk response
plans contained in the Sprint Risk Backlog; (ii) mon-
itoring risks that may affect Sprint, and (iii) assess-
ing the effectiveness of risk management processes
throughout the Sprint. The main benefit of this pro-
cess is that it allows project decisions to be based
on current information about the overall exposure to
project risk and individual project risks. This process
occurs throughout the Sprint, since risks may arise or
materialize throughout the project (PMI, 2017).
The step of evaluating the effectiveness of the risk
management processes proposed by RIMPRO is car-
ried out during the Sprint Retrospective meeting, as
this meeting aims to identify what worked well, what
can be improved and what actions will be taken to im-
prove several aspects that may limit the speed of the
project, such as deficiencies in the risk management
processes. Such an evaluation must be made with
all Scrum Team members at the Sprint Retrospective
meeting, as it is the moment when the whole team
must present the lessons learned in each Sprint for
the benefit of future projects and subsequent Sprints
of the current project. In this way, plans to improve
risk management processes can be established, to be
applied in Sprints and the following projects (PMI,
2017; Sutherland and Sutherland, 2014).
To ensure that stakeholders are aware of the cur-
rent risks, Sprint must be continuously monitored.
ICEIS 2021 - 23rd International Conference on Enterprise Information Systems
36
Risk Monitoring uses project information to deter-
mine whether (Alliance, 2017): the responses to the
implemented risks are effective; the current project
risks have changed; the status of individual risks iden-
tified in Sprint has changed; new risks of individual
projects have arisen; the risk management approach
is still appropriate; risk management processes have
been followed; the contingency surplices for cost or
time require modifications.
Risk reviews are scheduled regularly and should
examine and document the effectiveness of the risk
responses made in the Sprint Risk Backlog. Risk
reviews can also result in identifying newer risks,
including secondary risks arising from responses to
agreed risks, reassessing current risks, closing out
risks that are out of date, identifying problems that
arise as a result of risks that have occurred, and iden-
tifying lessons learned for implementation in subse-
quent Sprints or similar projects in the future. The
Sprint risk review should be conducted as part of
a regular project status meeting, such as the Daily
Scrum (Alliance, 2017; Sutherland and Sutherland,
2014).
Figure 2: SAPM-Extended Architecture.
4 RIMPRO ASSESSMENT
To evaluate RIMPRO, we automated its processes
through a computational module attached to the com-
putational tool called System to Aid Project Manag-
ing (SAPM). SAPM has been developed with the par-
ticipation of one of the authors. The automation of
risk management processes is crucial since the lack
of knowledge of professionals in this knowledge area,
as well as the scarcity of computational tools, are bar-
riers to the execution of risk management processes
(Gregoriades et al., 2011), such as those foreseen by
SAPM. The development of a computational mod-
ule facilitates the application of RIMPRO in Scrum
projects. SAPM allowed the management of tradi-
tional projects, based on the knowledge areas pro-
vided by PMBoK, as well as an independent alter-
native for agile project management through Scrum
(Mendonc¸a et al., 2014). The incorporation of RIM-
PRO into SAPM referred to in this paper as SAPM-
Extended has allowed the execution of traditional pro-
cesses foreseen in PMBoK, in an agile way, according
to Scrum. Figure 2 shows the general architecture es-
tablished for SAPM-Extended.
We performed the RIMPRO assessment from
September to October 2018. Students, both under-
graduate and graduate who had already completed
the discipline of Software Engineering, as well as IT
professionals, participated in the assessment process.
The assessment process was carried out by 31 partic-
ipants, of which 12.9% are IT professionals, 22.6%
are graduate students, and 64.5% are undergraduate
students. Although most participants in the sample
are not IT professionals, participating students have
contact with projects that use PMBoK and Scrum.
One of the authors invited all participants of the
assessment to a meeting, in which RIMPRO and
SAPM-Extended were presented and possible doubts
were resolved. The participants had the opportunity
to simulate a Sprint, in which risks were identified
and the probability and impact were measured by the
participants. At the end of the meeting, a guide for
using the RIMPRO and an assessment form were sent
to all participants by email. In the 15 days following
the meeting, everyone was free to continue using the
RIMPRO on the Web and fill out the assessment form.
We used the Likert Scale (Boone and Boone,
2012) with ”Strongly Disagree”, ”Disagree”, ”Nei-
ther Agree Nor Disagree”, ”Agree” and ”Strongly
Agree” items, to evaluate RIMPRO under the follow-
ing three statements (S):
S1: I am satisfied with the ease of learning and
use of RIMPRO;
S2: PMBoK’s adaptation by RIMPRO to manage
risks involving PO contributes to the management
of agile projects as well as managing risks related
to PO’s roles;
S3: The risk management divided by Sprints, in-
stead of addressing in a general way as it occurs
in traditional projects, contributes to the risk man-
agement in agile projects.
A Risk Management Framework for Scrum Projects
37

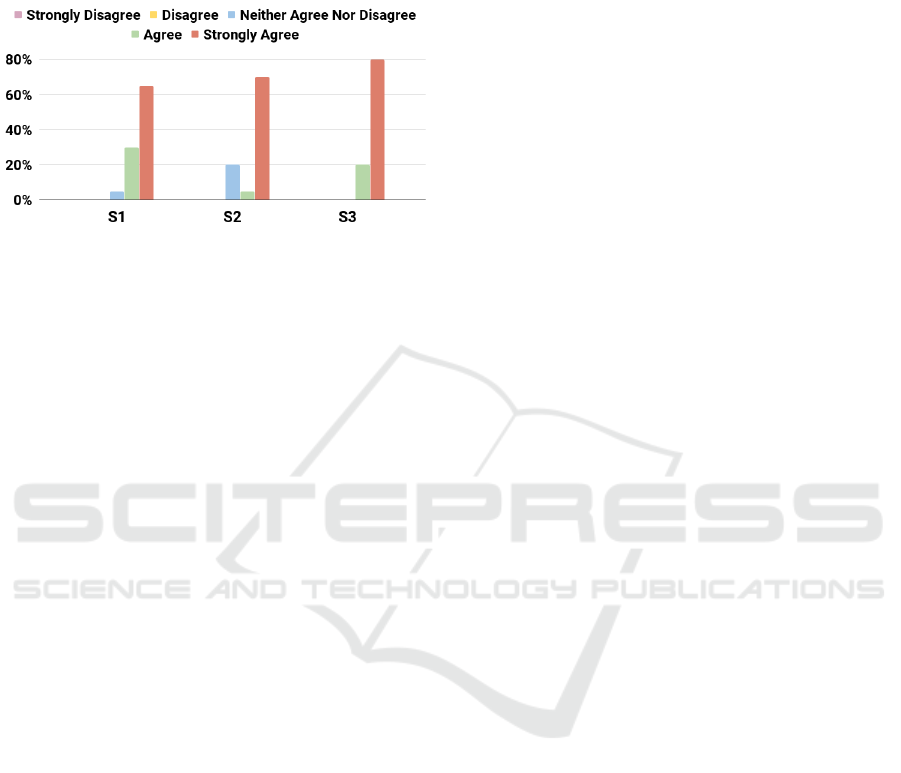

The obtained results are illustrated in Figure 3. We
also provided two open questions to the participants
expressing their opinions about RIMPRO’s strengths
and weaknesses.
Figure 3: Assessment Histogram of RIMPRO.
From the analysis of the answers obtained from the
participants shown in Figure 3, it is possible to verify
a satisfactory result, since more than 50% of the par-
ticipants strongly agreed with all the statements. We
can conclude that RIMPRO is easy to learn and use,
since the way to classify the risks through Sprints and
the prioritization of the risks through the adaptation
of Planning Poker, proposed in this work, are analo-
gous to the stage of requirements engineering. In this
way, the use of RIMPRO in real projects looks sim-
ple and it requires few hours of training because the
risks are documented and catalogued in a similar way
to the requirements of agile software projects.
As for strengths, the participants concluded that
iteratively managing risks is beneficial because the
Scrum Team has few members, and the project budget
is relatively smaller than traditional projects. Thus,
instead of monitoring all risks throughout the project,
only risks that can affect a given Sprint are monitored.
It is relevant when it comes to risks involving the PO
because (s)he is present throughout the project and,
so, the probability of occurrence and the impact of the
risks involved may vary throughout Sprint. Conse-
quently, risks monitored in a Sprint may not be moni-
tored in subsequent Sprints, and vice versa. As for the
weaknesses, even the SAPM-Extended having a pre-
vious database containing the risks exposed in Section
2, the participants noted a limited amount of risks in-
volving the PO’s roles to guide the execution of RIM-
PRO through the project, as well as lessons learned
from previous projects. They also stressed the impor-
tance of assisting the Scrum Team in discussing new
risks that may arise.
5 RELATED WORKS
With respect to project risk management, some stud-
ies address this topic to increase the success rates in
the development of software projects. (Janjua et al.,
2016) stated that it is necessary to use risk manage-
ment practices. Indeed, (Pasha et al., 2018) point out
that the risks related to large-scale software develop-
ment are challenging, and they provide a compara-
tive study of the risks found in the literature related
to small and large-scale software development. (Bista
et al., 2017) also emphasize the importance of risk
management for software projects, to propose a new
approach to estimate these risks using the analyzed
regression method, which consists of using a collec-
tion of statistical techniques for models that describe
the reasonable relations between several explanatory
variables, the use of which is described quantitatively
on a determined process.
Regarding risk management related to the ag-
ile approach to software development, some studies
highlight the need to identify and analyze such risks.
(Khatri et al., 2014) suggested a set of good risk man-
agement practices applied to agile methods, but it
has not been validated. (Moran, 2014) presented a
generic process for performing risk management in
agile methods. However, it has not been validated.
(Alsaqaf et al., 2017) exposed the main risks related
to software quality, emphasizing that agile approaches
neglect the software quality requirements. In turn,
(Andrat and Jaswal, 2015) warned that, unlike the tra-
ditional approach, risks related to the agile approach
to software development are little known. Consider-
ing Scrum, (Tavares et al., 2019b) warns that such a
method does not specify project risk management ac-
tivities, concluding that classic risk management pro-
cesses, such as planning, analyzing, and planning re-
sponses to risks, must be incorporated and adapted to
Scrum. Finally, (Tavares et al., 2019a) consider that
the PO plays the most important role and its risk man-
agement practices are strongly recommended. This
motivated this work, by presenting RIMPRO as a use-
ful framework for managing risks involving the PO.
The adaptation of the PMBoK knowledge area
namely risk management exposed in this paper is
something that we did not find in any of the analyzed
studies. Besides, even showing the importance of PO
in Scrum Teams, we have not found studies that have
identified the risks related to PO activities or proposed
an effective way to manage them. Regarding all re-
searches related to risk management of agile methods,
none has any assessment process, highlighting the im-
portance of the RIMPRO assessment carried out.
RIMPRO differs from a general risk management
ICEIS 2021 - 23rd International Conference on Enterprise Information Systems
38
approach because of two features. The classifica-
tion presented in Section 2 intends to guide RIMPRO
users to classify PO risks, as described in Section
3.2. Also, the data obtained by surveying the risks
involving the PO was used to create a database for
the SAPM-Extended that was used to automate RIM-
PRO. Thus, during the RIMPRO assessment, users
were able to access the risk database through SAPM-
Extended. The participants considered this database
as a strong point that helped to understand RIMPRO,
although it still requires expansion. Another feature
that distinguishes RIMPRO from a general risk man-
agement approach is the fact that the Risk Master is
the PO because the PO is the most important mem-
ber of the Scrum Team for risk management, and the
risks can be related to the client and the PO is the
most suitable member to treat them, since (s)he is the
one, among the other members of the Scrum Team,
who has direct contact with the client throughout the
project.
6 CONCLUSION
Although Scrum is one of the most widely used agile
methods today, it does not have a structured way of
managing risks that may arise throughout the project.
This work contributed to structuring the RIMPRO to
support the Scrum Team to implement a systematic
way of managing risks, based on the PMBoK Guide,
without interfering with the agile values of Scrum.
Structuring a risk management framework for agile
projects contributes to this area maturity and, conse-
quently, promotes the advancement of research aimed
at its improvement.
The results obtained through the preliminary
RIMPRO assessment are promising. This assessment
provides evidence of the feasibility of RIMPRO in
supporting the Scrum Team by taking decisions based
on the risks related to the PO that may arise in an ag-
ile and satisfactory manner. However, we have not
applied RIMPRO to real agile projects. Furthermore,
another limitation of RIMPRO is the non-use of quan-
titative techniques to perform risk analysis. There-
fore, we intend to evaluate the effectiveness of RIM-
PRO by conducting experiments and realistic case
studies in companies, as well as improving RIMPRO
by using quantitative risk analysis without infringing
agile manifesto.
ACKNOWLEDGEMENTS
Thanks to God for everything, as well as Con-
selho Nacional de Desenvolvimento Cient
´
ıfico
e Tecnol
´
ogico (CNPq) and Coordenac¸
˜
ao de
Aperfeic¸oamento de Pessoal de N
´
ıvel Superior
(CAPES) for the financial support.
REFERENCES
Alliance, A. (2017). Agile Practice Guide, volume 1. Buku-
pedia.
Alsaqaf, W., Daneva, M., and Wieringa, R. (2017). Ag-
ile quality requirements engineering challenges: First
results from a case study. In 2017 ACM/IEEE Interna-
tional Symposium on Empirical Software Engineering
and Measurement (ESEM), pages 454–459.
Andrat, H. and Jaswal, S. (2015). An alternative approach
for risk assessment in scrum. In 2015 International
Conference on Computing and Network Communica-
tions (CoCoNet), pages 535–539. IEEE.
Asghar, A. R., Tabassum, A., Bhatti, S. N., and Jadi, A. M.
(2017). Impact and challenges of requirements elicita-
tion & prioritization in quality to agile process: Scrum
as a case scenario. In 2017 International Conference
on Communication Technologies (ComTech), pages
50–55. IEEE.
Bista, R., Karki, S., and Dongol, D. (2017). A new approach
for software risk estimation. In 2017 11th Interna-
tional Conference on Software, Knowledge, Informa-
tion Management and Applications (SKIMA), pages
1–8.
Boone, H. N. and Boone, D. A. (2012). Analyzing likert
data. Journal of extension, 50(2):1–5.
Curcio, K., Navarro, T., Malucelli, A., and Reinehr, S.
(2018). Requirements engineering: A systematic
mapping study in agile software development. Jour-
nal of Systems and Software, 139:32–50.
Dalkey, N. and Helmer, O. (1963). An experimental ap-
plication of the delphi method to the use of experts.
Management science, 9(3):458–467.
de Godoi Contessoto, A., Sant’Ana, L. A., De Souza, R.
C. G., Val
ˆ
encio, C. R., Doneg
´
a, G. F., Amorim, A. R.,
and Esteca, A. M. N. (2016). Improving risk identi-
fication process in project management. In Proceed-
ings of the International Conference on Software En-
gineering and Knowledge Engineering, SEKE, pages
555–558.
Dikert, K., Paasivaara, M., and Lassenius, C. (2016). Chal-
lenges and success factors for large-scale agile trans-
formations: A systematic literature review. Journal of
Systems and Software, 119:87–108.
Dingsøyr, T., Nerur, S., Balijepally, V., and Moe, N. (2012).
A decade of agile methodologies: Towards explaining
agile software development. Journal of Systems and
Software, 85(6):1213 – 1221.
Elghariani, K. and Kama, N. (2016). Review on agile re-
quirements engineering challenges. In 2016 3rd In-
ternational conference on computer and information
sciences (ICCOINS), pages 507–512. IEEE.
A Risk Management Framework for Scrum Projects
39
Faceli, K., Lorena, A. C., Gama, J., and Carvalho, A. C. P. d.
L. F. d. (2011). Intelig
ˆ
encia artificial: uma abordagem
de aprendizado de m
´
aquina. LTC.
Fitriani, W. R., Rahayu, P., and Sensuse, D. I. (2016). Chal-
lenges in agile software development: A systematic
literature review. In 2016 International Conference on
Advanced Computer Science and Information Systems
(ICACSIS), pages 155–164. IEEE.
Gandomani, T. J. and Nafchi, M. Z. (2016). Agile transition
and adoption human-related challenges and issues: A
grounded theory approach. Computers in Human Be-
havior, 62:257–266.
Gold, B. and Vassell, C. (2015). Using risk management to
balance agile methods: A study of the scrum process.
In 2015 2nd International Conference on Knowledge-
Based Engineering and Innovation (KBEI), pages 49–
54. IEEE.
Gregoriades, A., Lesta, V. P., and Petrides, P. (2011).
Project risk management using event calculus (s). In
SEKE, pages 335–338.
Inayat, I., Salim, S. S., Marczak, S., Daneva, M., and
Shamshirband, S. (2015). A systematic literature re-
view on agile requirements engineering practices and
challenges. Computers in human behavior, 51:915–
929.
Janjua, U. I., Jaafar, J., and Lai, F. W. (2016). Expert’s
opinions on software project effective risk manage-
ment. In 2016 3rd International Conference on Com-
puter and Information Sciences (ICCOINS), pages
471–476. IEEE.
Khatri, S. K., Bahri, K., and Johri, P. (2014). Best prac-
tices for managing risk in adaptive agile process. In
Proceedings of 3rd International Conference on Reli-
ability, Infocom Technologies and Optimization, pages
1–5. IEEE.
Mendonc¸a, L. T., Esteca, A. M. N., De Souza, R. C. G., San-
tos, A. B., and Val
ˆ
encio, C. R. (2014). A scrum sup-
port system integrated to a web project management
environment. In 29th International Conference on
Computers and Their Applications, pages 111–116.
Moran, A. (2014). Agile risk management. In Agile Risk
Management, pages 33–60. Springer.
Pasha, M., Qaiser, G., and Pasha, U. (2018). A critical anal-
ysis of software risk management techniques in large
scale systems. IEEE Access, 6:12412–12424.
PMI, editor (2017). A Guide to the Project Management
Body of Knowledge (PMBOK Guide). Project Man-
agement Institute, 6 edition.
Siqueira, D. L., Fontoura, L. M., Bordini, R. H., and
de Lima Silva, L.
´
A. (2017). A knowledge engi-
neering process for the development of argumentation
schemes for risk management in software projects. In
Proceedings of the 29th International Conference on
Software Engineering and Knowledge Engineering.
Sutherland, J. and Sutherland, J. (2014). Scrum: the art of
doing twice the work in half the time. Currency.
Tavares, B. G., da Silva, C. E. S., and de Souza, A. D.
(2019a). Practices to improve risk management in
agile projects. International Journal of Software En-
gineering and Knowledge Engineering, 29(03):381–
399.
Tavares, B. G., da Silva, C. E. S., and de Souza, A. D.
(2019b). Risk management analysis in scrum software
projects. International Transactions in Operational
Research, 26(5):1884–1905.
ICEIS 2021 - 23rd International Conference on Enterprise Information Systems
40
